TEMPORARY FACILITIES


SITE OPTION 1


SITE OPTION 2

PROGRESS OF THE SITES ACTUAL PROJECT CONSTRUCTION

Site Option 1: Rio Alejandro Energy Park
✅ Enviromental Permit obtained

✅ Construction Permits obtained

✅ Temporary access road finished and final access road ongoing

✅ Site levelling works for both the Power Block and the Regasification Plant (Onshore part of the LNG Terminal) finished.

✅All preparation works are being carried out to start foundations in order to be ready before the equipment arrives at site.

✅ Temporary facilities are finished

Site Option 2: Isla Margarita
✅ Sea-bed Concession obtained and sub-lease Concession obtained;
✅ Pier construction in progress

STRATEGIC ALLIANCES

AREA FOR THE DEVELOPMENT OF
THE SINOLAM LNG PROJECT


VEGETATION REMOVAL
DEFORESTATION AT 43.4 Ha

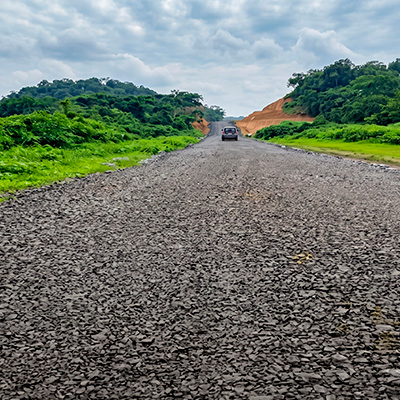

TEMPORAL ACCESS ROAD 4KM

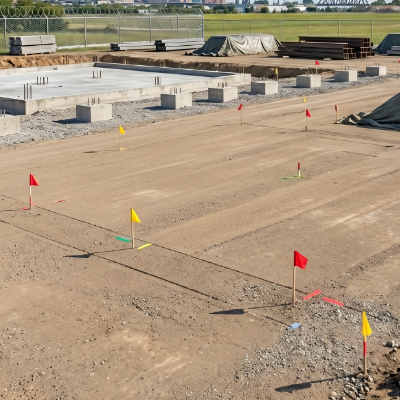

SITE LEVELLING


TOTAL OF EXCAVATED & BACKFILLED MATERIAL = 900,000 M3 (x 2)  1,800,000 M3

AUGUST. 2018


NOW

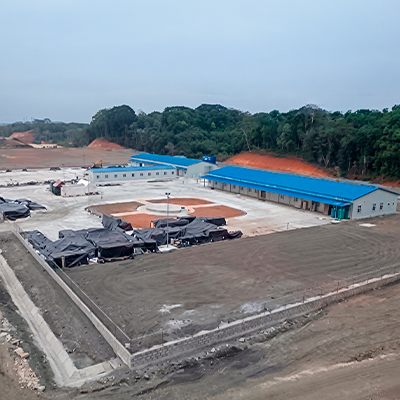

TEMPORARY FACILITIES
